Universal United Kingdom Resort Construction: January to April 2026

Universal United Kingdom Resort construction became clearly visible between January and April 2026, as enabling works began across the future theme park and resort site near Bedford.
The Special Development Order came fully into force on 12 January 2026. In the days and weeks that followed, temporary haul roads, construction compounds, staging areas and extensive archaeological excavations began to change parts of the former Kempston Hardwick brickworks site.
At this stage, the development was still commonly known as Universal Studios UK. The official Universal United Kingdom Resort name would not be unveiled until June 2026.
This timeline follows the progress recorded by Wandering Northerner between January and April 2026, before activity increased further during May, June and July.
Universal United Kingdom Resort construction: January–April 2026 at a glance
The main developments during the period included:
- The Special Development Order coming fully into force.
- The beginning of visible enabling works.
- Temporary haul roads forming through the Core Zone.
- Archaeological excavations expanding across several areas.
- New construction compounds and staging areas appearing.
- Work progressing at the former brickworks entrance beside Manor Road.
- A large staging area forming at the end of a new haul road.
- Further activity beginning around the West Gateway and Transport Hub.
These were not yet the major theme park earthworks seen later in 2026. Much of the activity involved creating access, investigating the ground and preparing areas for the larger construction programme that would follow.
January 2026: Enabling works begin
January opened a new chapter for the Bedford resort project.
The Special Development Order came fully into force on 12 January 2026, allowing the project to move into its approved enabling-work programme.

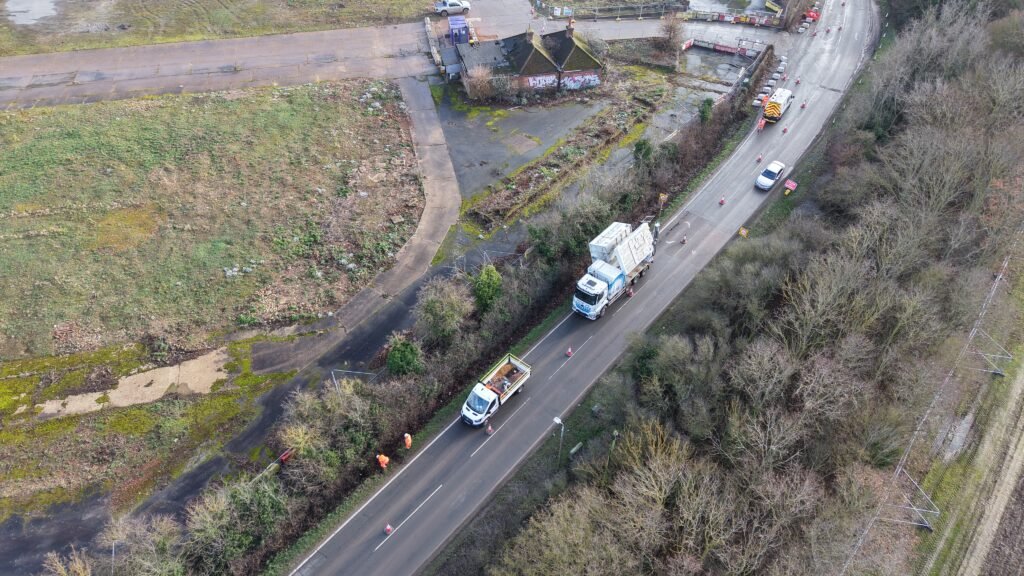

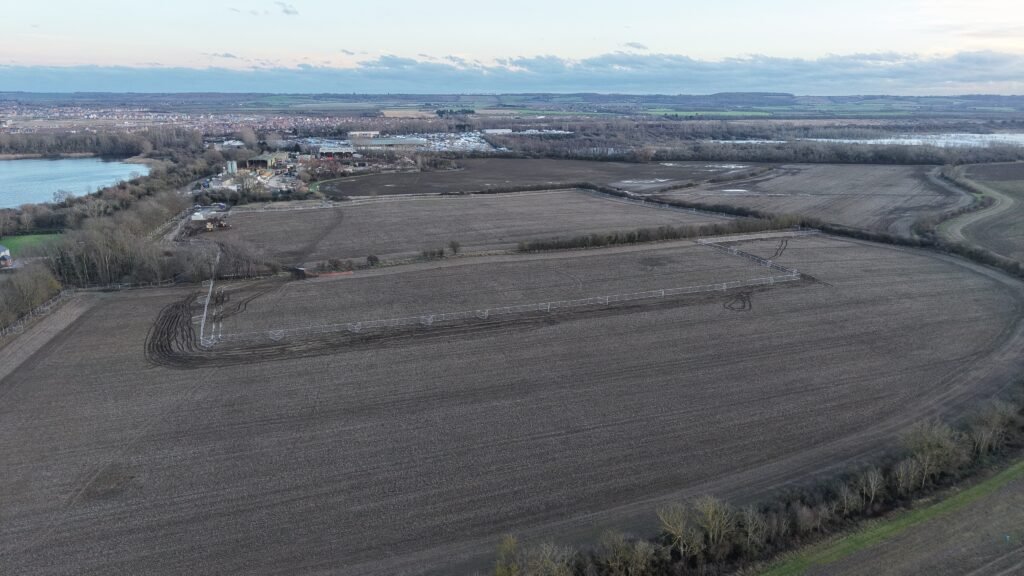

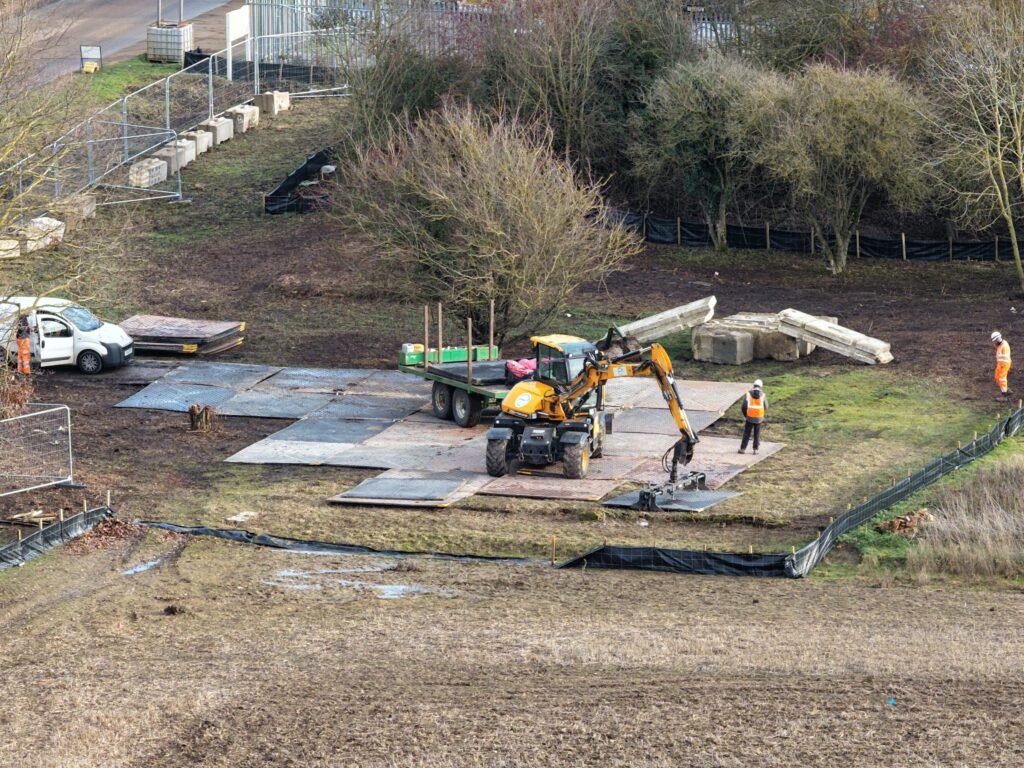

Just two days later, Wandering Northerner recorded the first construction update of the year. Activity on the site had noticeably increased, although the development still looked very different from the large earthmoving operation that would emerge later.
The early work was concentrated on temporary access, site organisation and preparation rather than the construction of rides, hotels or permanent resort buildings.
Temporary haul roads appear in the Core Zone

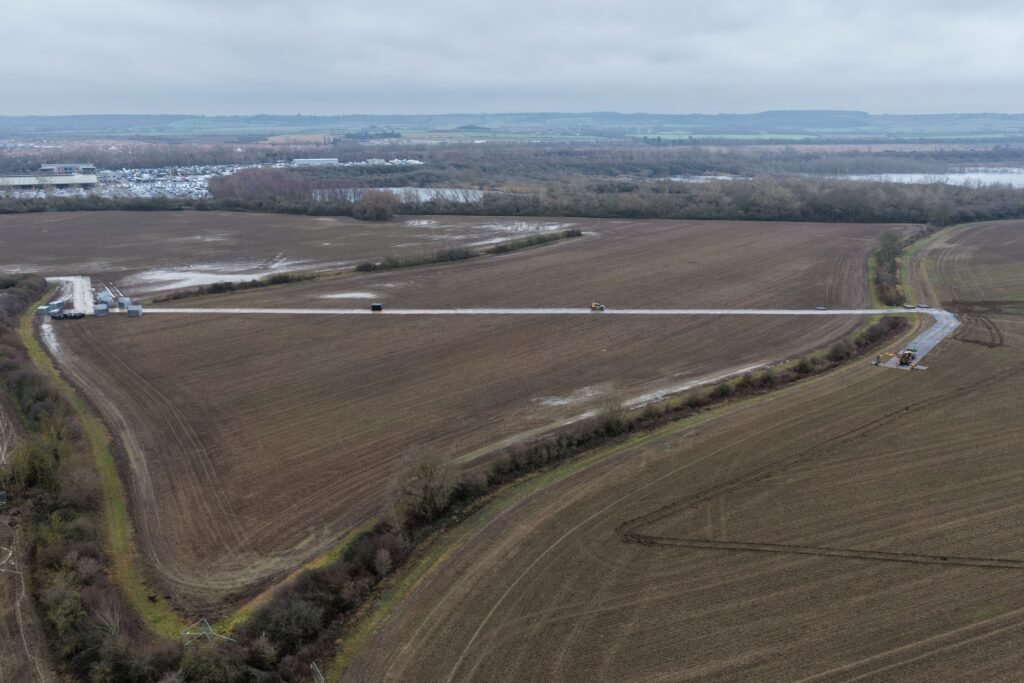

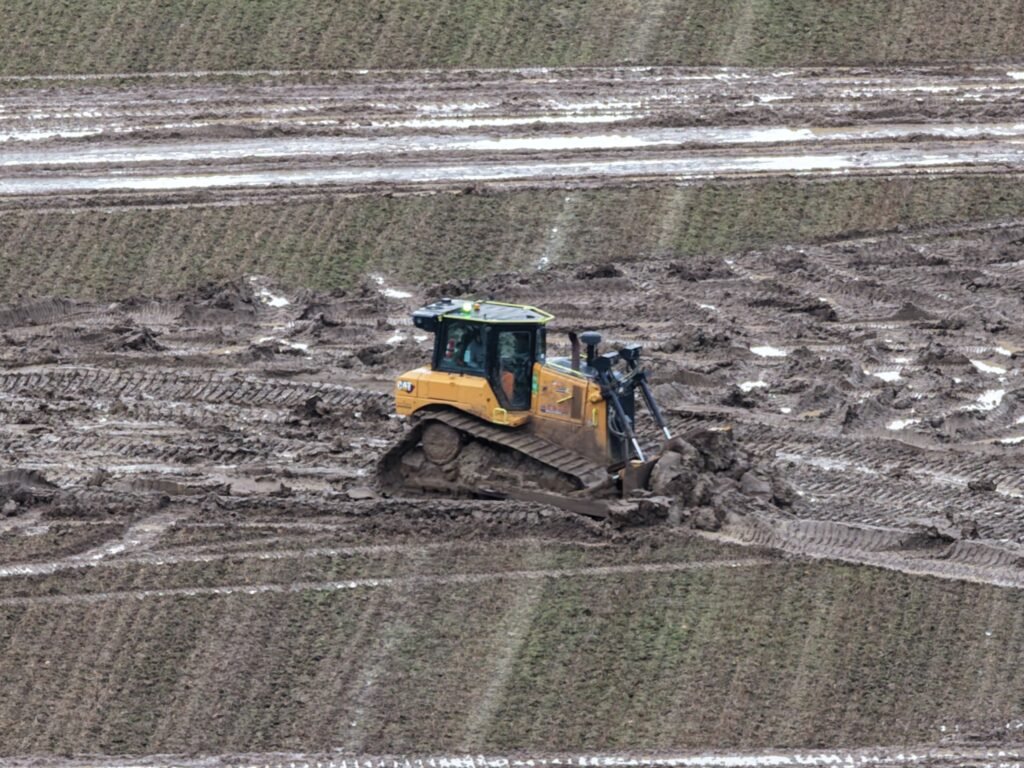

One of the first clearly visible changes was the formation of temporary haul roads through the Core Zone.
By 20 January, work was continuing on these routes across the future theme park land. The roads provided a way for plant, site vehicles and construction teams to move through areas that had previously remained open fields.
The appearance of these routes was significant because it showed how the enormous site was beginning to be organised into active work areas.
Although the temporary roads were still relatively narrow and incomplete, they provided an early outline of how construction traffic would move between compounds, archaeological excavations and access points.
Compounds and fenced work areas
Temporary compounds and fenced areas also became more noticeable during January.
These early compounds supported the enabling works and provided space for equipment, vehicles and site operations. Their appearance did not mean that permanent theme park construction had started, but it was a clear indication that contractors were beginning to establish themselves across the development.
By the end of January, the first phase of work could be seen through:
- Temporary haul-road construction.
- New fencing and controlled work areas.
- Construction compounds.
- Plant and vehicle movements.
- Preparation for expanding archaeological investigations.
January therefore marked the transition from an approved development site into an active enabling-works project.

February 2026: Archaeological works expand

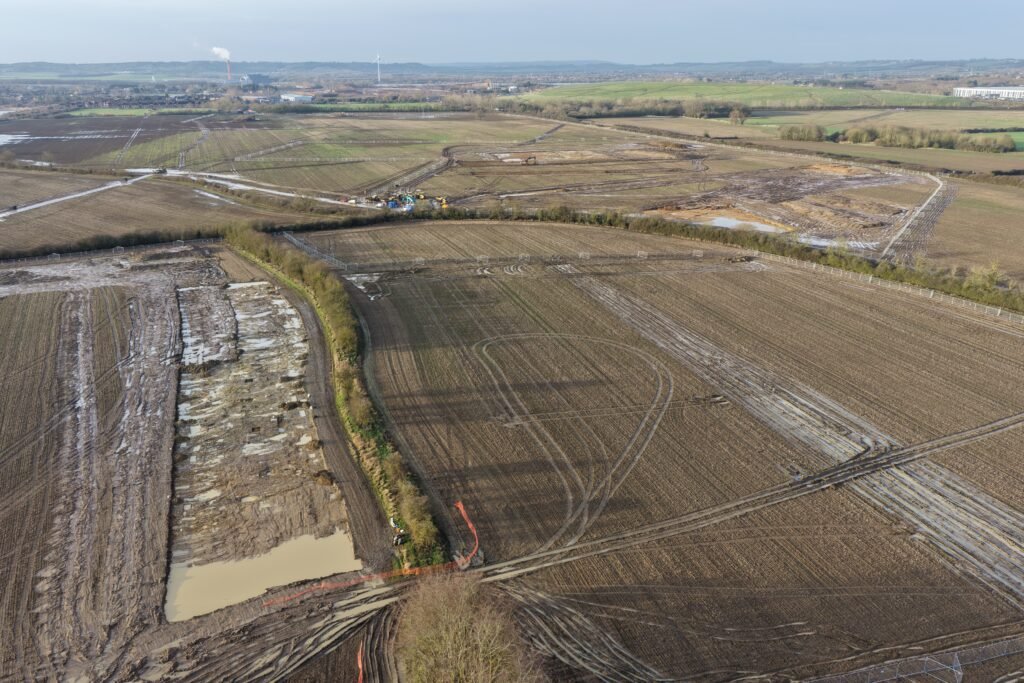

During February, archaeology became one of the largest and most visible activities across the site.

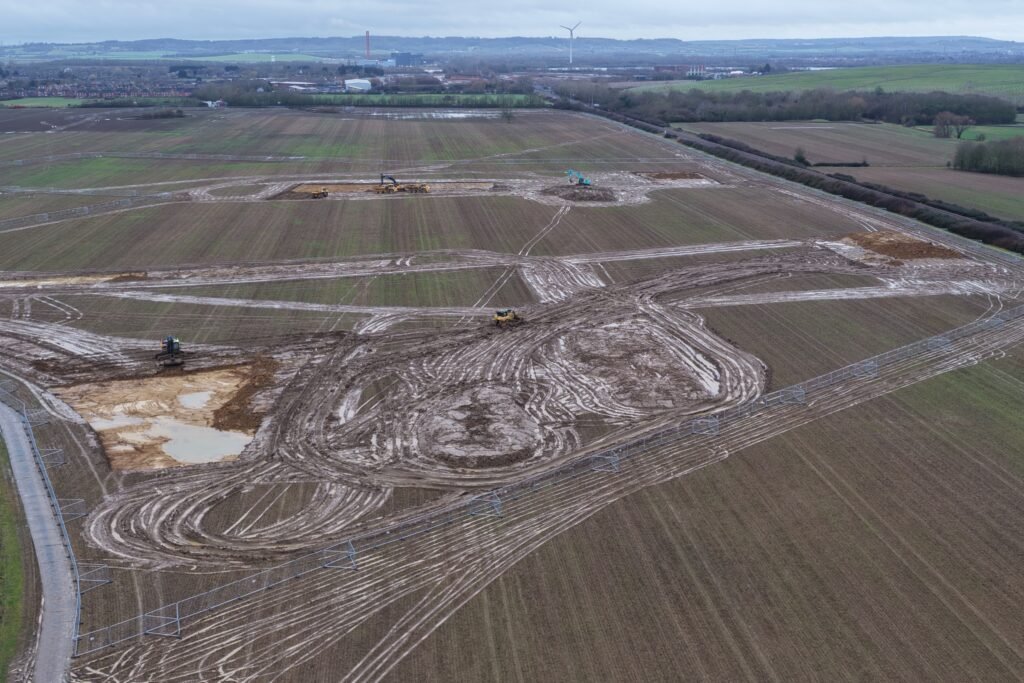

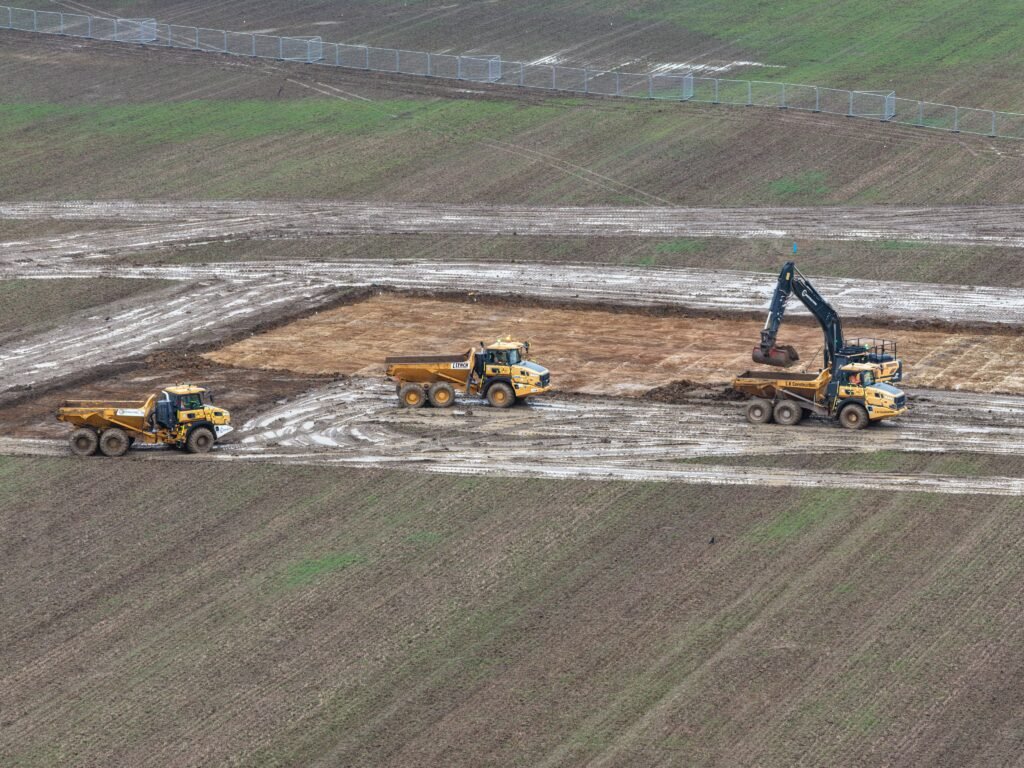

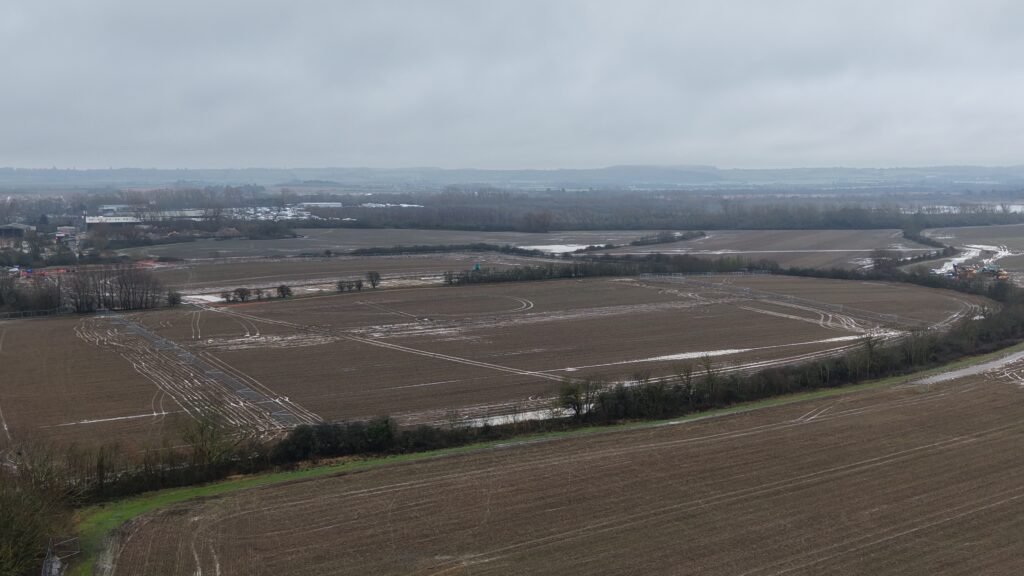

By February, archaeological works were well underway within the future resort development. Large areas of land had been cleared and opened for investigation, particularly within the Core Zone.
Rather than small isolated trial trenches, the work was beginning to cover substantial areas. This reflected the scale of the archaeological programme required before sections of the site could be released for later construction.
A site still dominated by preparation
The resort site remained a mixture of different landscapes during February.
Some areas contained active excavations, fencing, compounds and temporary routes. Other fields remained largely untouched and continued to look much as they had before the Special Development Order came into force.
This contrast demonstrated how the enabling programme was progressing in stages.
Before a particular area could move towards major earthworks, it could require:
- Archaeological investigation.
- Ground preparation.
- Temporary access.
- Fencing and site security.
- Contractor mobilisation.
- Clearance for later construction activity.
The work visible in February was therefore mainly preparatory. It was nevertheless essential to the project and represented a noticeable increase in activity compared with the end of 2025.
Core Zone archaeology
The future Core Zone contains the principal theme park development area.

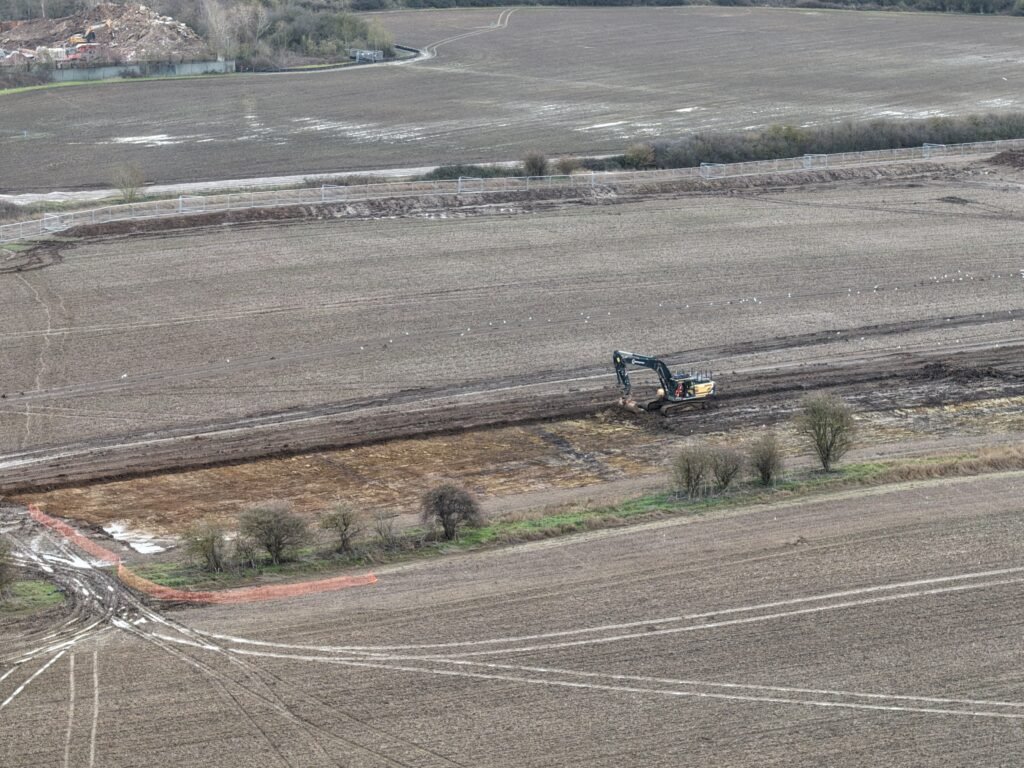

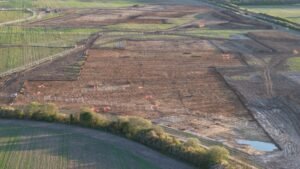

During February, archaeological teams continued examining cleared sections of this land. The excavations revealed the scale of investigation needed before the ground could be handed over for later phases of work.

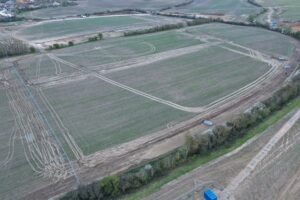

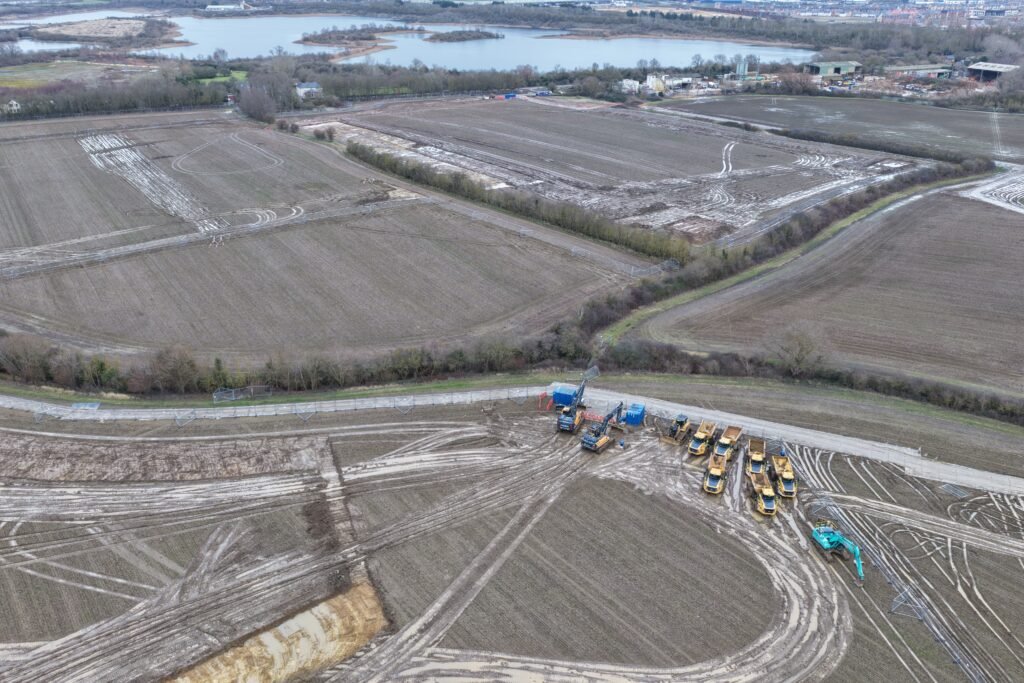

Aerial views made the archaeological areas particularly distinctive, with excavated shapes, soil piles and vehicle routes standing out from the surrounding green fields.
By the end of the month, pre-construction archaeological work remained the most prominent activity across much of the site.

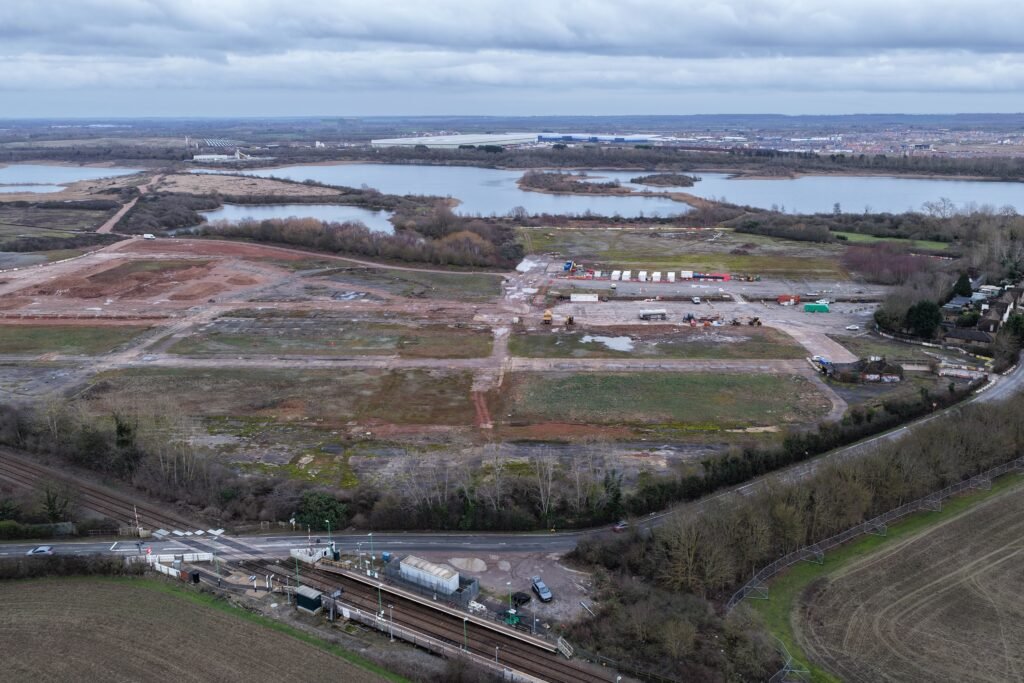

March 2026: Haul roads, compounds and entrances progress
March brought more visible changes across several parts of the development.
Archaeological work continued, but new construction routes, staging areas and activity around the former brickworks entrance began to make the wider enabling programme easier to follow.
Archaeology continues in the Core Zone
At the beginning of March, archaeologists were examining a large cleared area within the Core Zone.
A second, smaller compound had also appeared, adding to the growing number of operational areas across the site.
The archaeological excavations were no longer confined to one isolated location. Different sections of the future resort were being investigated at the same time, each with its own fencing, temporary access and supporting equipment.
Changes beside Manor Road

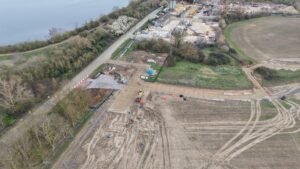

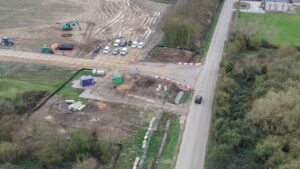

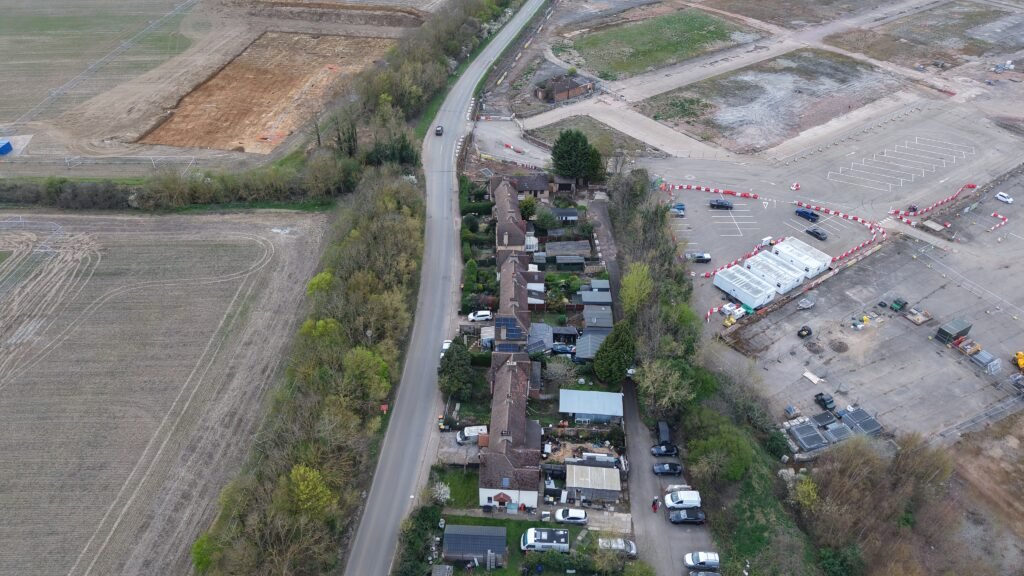

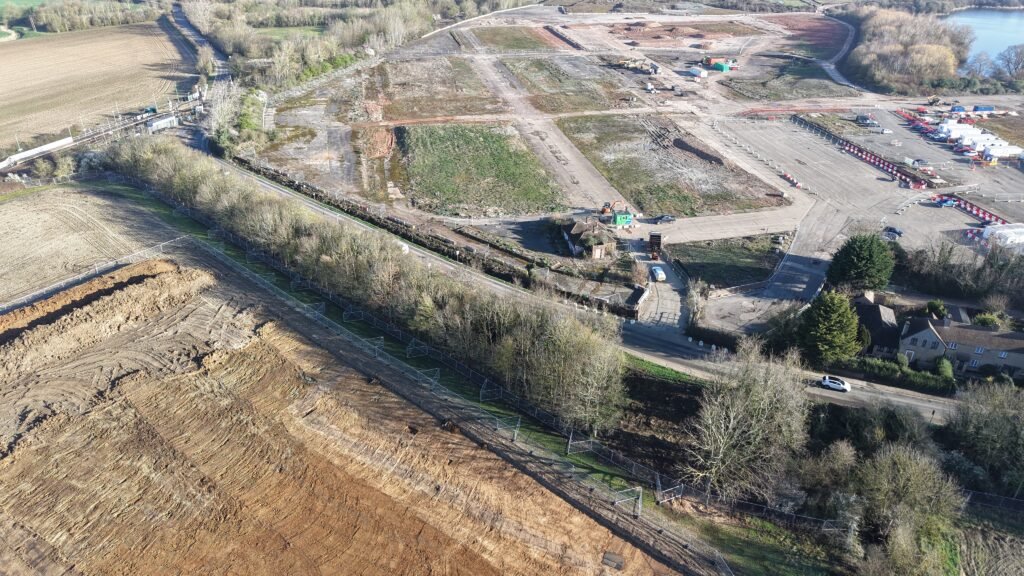

By the middle of March, work was also progressing at the former brickworks entrance beside Manor Road.
This entrance would become increasingly important as activity expanded across the former industrial site and surrounding land.
The changes visible during March included work around the access itself and increasing activity on the land immediately behind it.
Although the entrance was not yet operating at the scale seen later in the year, the work demonstrated that existing access points were being adapted to support the construction programme.


The Transport Hub

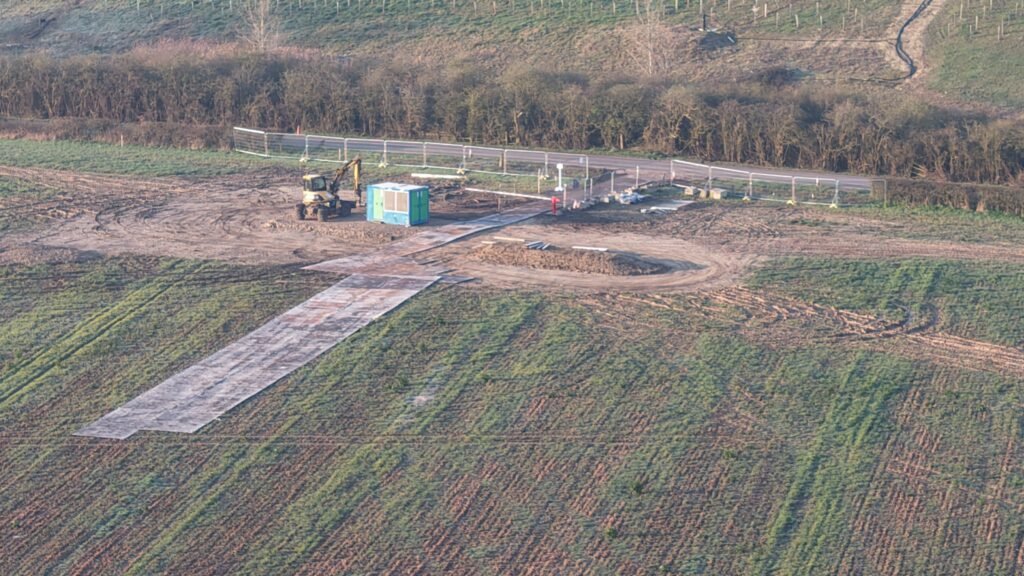

Work started in the Transport Hub (West Gateway Zone) off Broadmead Road in March 2026, this was followed by a small archaeology area near the brook running along the zone.

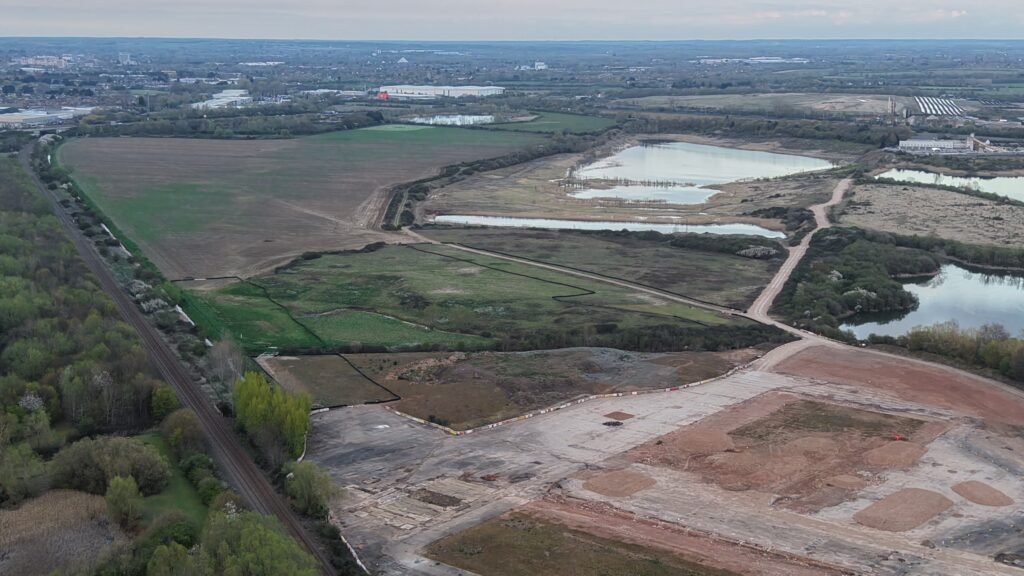

The Lake Zone

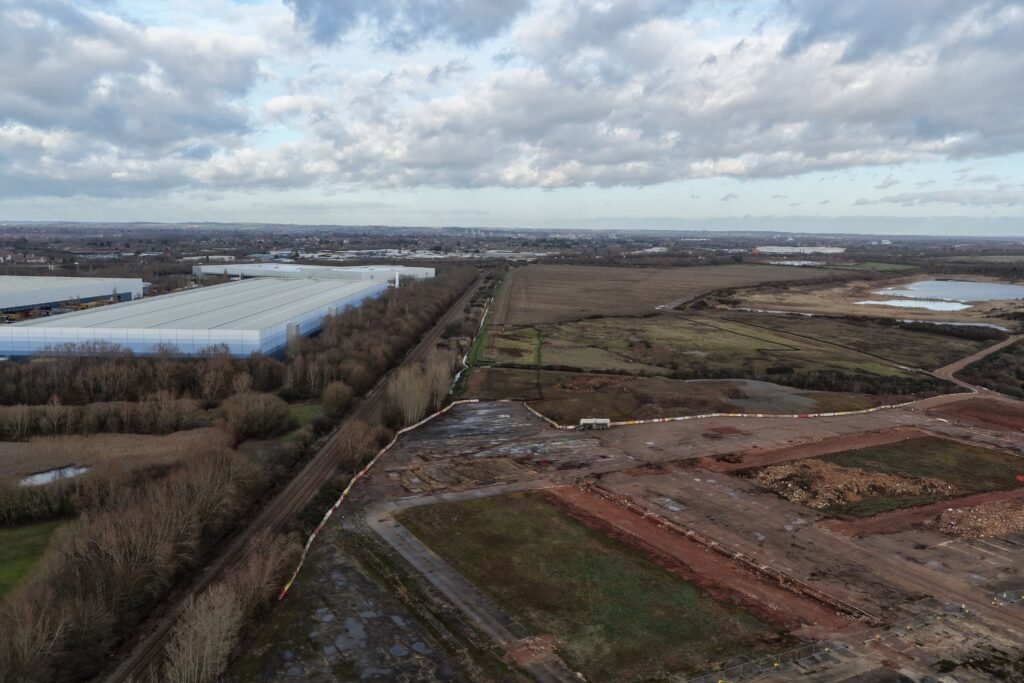

During March 2026, the Lake Zone remained relatively quiet with only occasional test digs being seen around the water bodies.

April 2026: Work spreads across more of the site
April saw further progress to the haul-road network, compounds and staging areas.
The most visible work was still enabling activity rather than construction of the finished resort, but operations were now spreading across the Core Zone, West Gateway and Transport Hub areas.

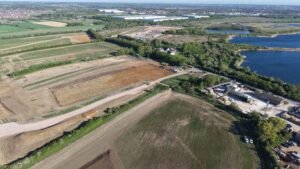

Further work to the Core Zone haul road

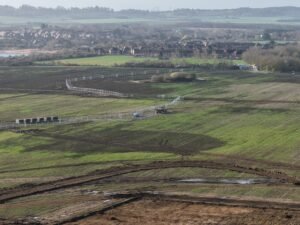

At the beginning of April, haul roads and compounds remained central to the visible progress.

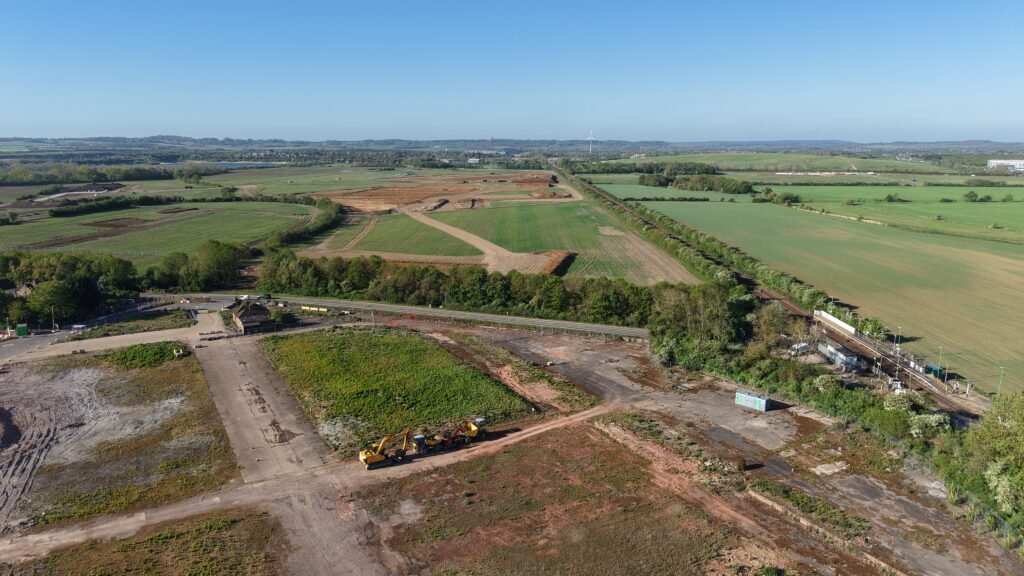

By 11 April, further work had been completed to the haul road and an additional staging pad was taking shape.
These prepared areas provided firm surfaces where construction vehicles could turn, wait, park or be organised away from the surrounding fields.
The increasingly developed haul-road system demonstrated that the project was preparing for a much larger number of vehicle and plant movements.
West Gateway and Transport Hub activity

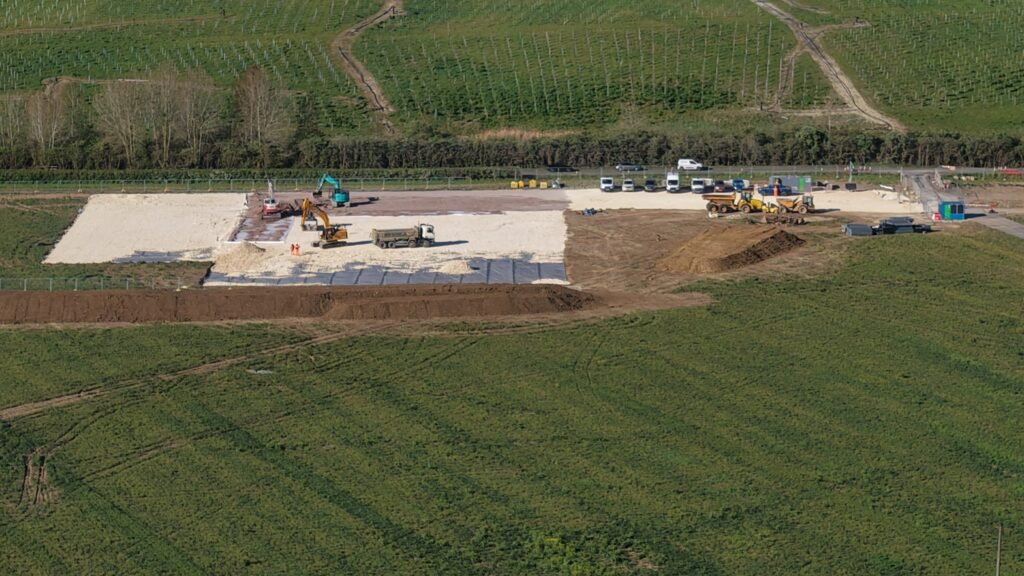

By 15 April, another staging area was under construction within the West Gateway and Transport Hub side of the development.
This showed that preparation was no longer concentrated solely within the Core Zone.
The future Transport Hub area lies between the main resort site and the A421. During April, construction preparation and archaeological activity became increasingly visible across this part of the project.
A new staging area provided a base for work in the western and railway-side sections of the development, while temporary routes helped connect these areas with the wider site.

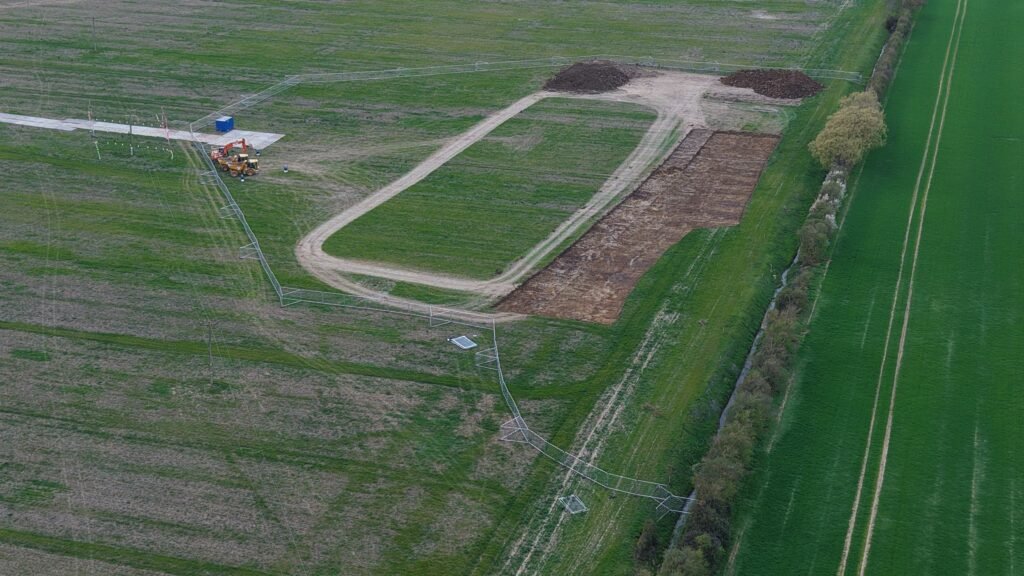

Archaeology continues across the Transport Hub

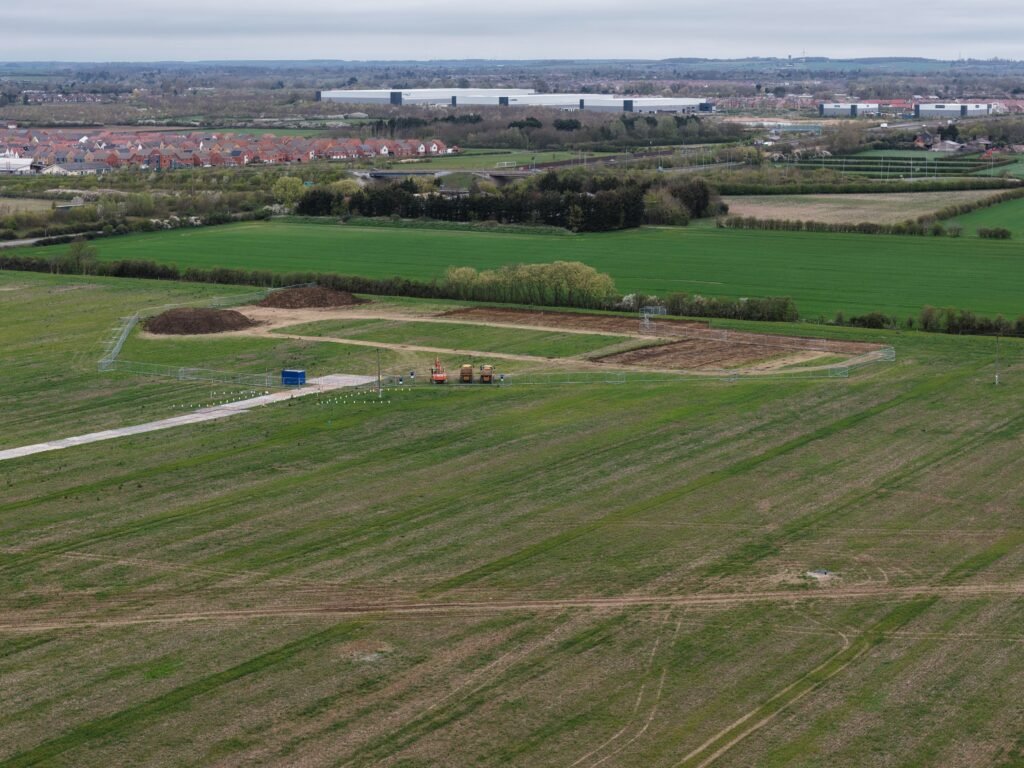

Archaeological works were also continuing within the Transport Hub during the second half of April.
The excavations formed part of the same wider programme taking place across the Core Zone and other development areas.
From the air, the Transport Hub showed a growing combination of:
- Archaeological investigations.
- Temporary fencing.
- Haul roads.
- Prepared staging areas.
- Construction compounds.
- Vehicle access routes.
The activity remained preparatory, but it demonstrated that multiple parts of the development were now moving forward at the same time.

A clear transformation by the end of April
At the start of January, much of the future resort still appeared to be open fields surrounding the remains of the former brickworks.
By the end of April, the site contained a growing network of active work areas.
Temporary roads crossed the Core Zone, large archaeological excavations occupied previously untouched fields and new staging areas had appeared in both the main development site and the Transport Hub.
The transformation was clearest when comparing aerial photographs from the beginning and end of the four-month period.
The major changes included:
- New and extended haul roads.
- Large archaeological excavation areas.
- Multiple compounds.
- Staging areas for construction vehicles.
- Activity around Manor Road.
- Preparation within the West Gateway and Transport Hub.
- A growing network of fenced construction areas.

From approval to an active construction site
Universal United Kingdom Resort construction between January and April 2026 established the foundations for the larger earthworks that followed.
The period began with the Special Development Order coming fully into force and ended with an increasingly connected network of haul roads, compounds, staging areas and archaeological investigations.
No theme park attractions or permanent resort buildings were under construction during these months.
Instead, contractors were creating the temporary infrastructure and completing the investigations needed before major ground preparation could move across larger areas of the site.
The work may have appeared gradual when viewed week by week, but the four-month transformation was considerable.
By the end of April:
- Enabling works were firmly underway.
- Temporary routes crossed several parts of the development.
- Archaeology had expanded across the Core Zone and Transport Hub.
- Large staging areas had been prepared.
- Construction compounds were becoming established.
- Activity was spreading beyond the original brickworks land.
- The site was ready for the more intensive programme seen during the summer.
What happened next?
Activity increased further during May 2026.
Broadmead Road closed for improvement works, new construction entrances progressed and utility investigations continued near the Transport Hub. Archaeological work and temporary routes also continued expanding across the development.
In June, the official Universal United Kingdom Resort name was unveiled, before major soil stripping and earthworks became increasingly visible during July.
Continue following the project:
- Universal United Kingdom Resort Construction – May 2026
- Universal United Kingdom Resort Construction – June 2026
- Universal United Kingdom Resort Construction – July 2026
- Universal United Kingdom Resort construction updates
Frequently asked questions
When did enabling works begin?
Enabling activity became clearly visible during January 2026, shortly after the Special Development Order came fully into force on 12 January.
What work took place between January and April 2026?
The main visible activities included temporary haul roads, archaeological excavations, construction compounds, staging areas and preparation around site entrances.
Had construction of the theme park begun?
The work during this period primarily involved enabling and archaeological activity. Permanent rides, attractions, hotels and theme park buildings were not yet under construction.
Why were archaeological excavations required?
Large areas needed to be archaeologically investigated and recorded before they could be released for later ground preparation and construction.
When did major earthworks begin?
More extensive soil stripping and earthmoving became visible later in 2026, particularly during June and July.
Follow Universal United Kingdom Resort construction
Follow the latest Universal United Kingdom Resort construction progress through Wandering Northerner’s monthly updates, photographs and videos.
The project is followed through regular site visits, original aerial photography, ground-level images, planning research and construction videos.
